<html><head><style>h1 {text-shadow: 1px 1px #111111;}</style></head><body><h1><p style="color:white"><b>North Carolina School of Science and Mathematics<br>Morganton, North Carolina</b></h1></body></html></p>

Case Study



Case Study
North Carolina School of Science and Mathematics in Morganton, North Carolina

North Carolina School of Science and Mathematics in Morganton, North Carolina

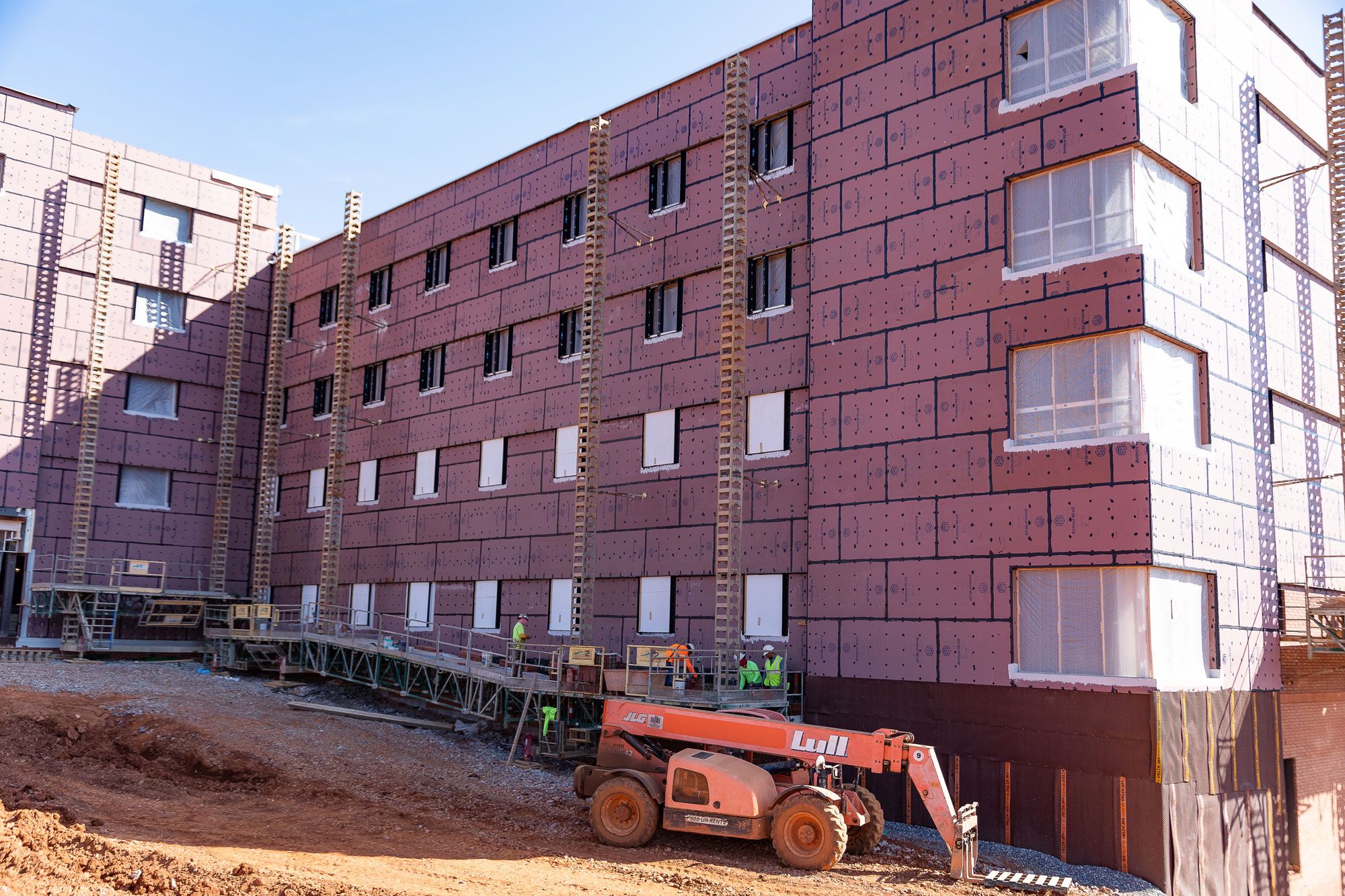

CS-10_Ronald_McDonald-House_Case_Study_Inline_Callout1_690x345




Building Type: Institutional, New Construction

Solution: ArmorWall Vapor Permeable (VP) and ArmorWall Below Grade (BG) Structural Insulated Sheathing

Sales Representative: Carolina REP

Architect: Duda|Paine Architects LLP

General Contractor: Barnhill Contracting, Co.

Installer: Precision Walls, Inc.





In 2019, Duda Paine Architects LLP was looking for a building enclosure solution that could be installed quickly and in many different types of weather to help clients save time and money on projects, particularly those taking place in the rainy spring season of North Carolina. Through an educational lunch-n-learn with Carolina REP’s Sales Representative Beau Preston, the firm’s staff was introduced to ArmorWall Structural Insulated Sheathing. Soon after, the firm completed a very extensive submittal process that led them to specify ArmorWall Vapor Permeable (VP) for a new project. Using ArmorWall VP saved an entire trade from being added to the job, reducing trade overlap and creating less work for the general contractor. Installer Precision Walls started with ArmorWall Below Grade (BG) around the foundation and followed up with ArmorWall Vapor Permeable (VP) on the above grade exterior walls. The installation went so fast that the Precision Walls install team had to slow down several times!








Designer Friendly

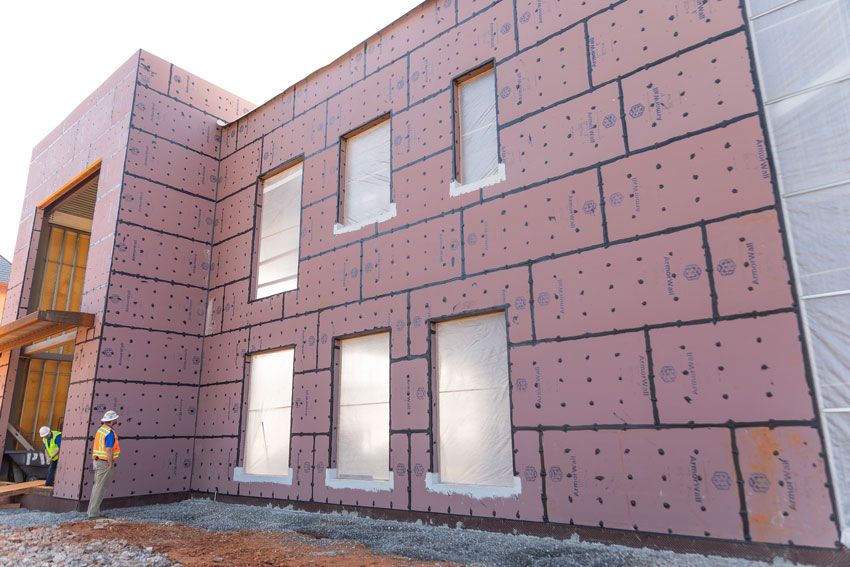

This building was one of the first to specify ArmorWall in its original plans. No longer requiring the exterior finish to go back to the stud provides an unrestrictive and uninterrupted blank canvas.

NFPA 285 Tested

ArmorWall passed the NFPA 285 on its own without a required cladding on the front. This allows most UL tested, listed, and approved exterior finishes to qualify as part of the complete wall assembly.

Fast Installation

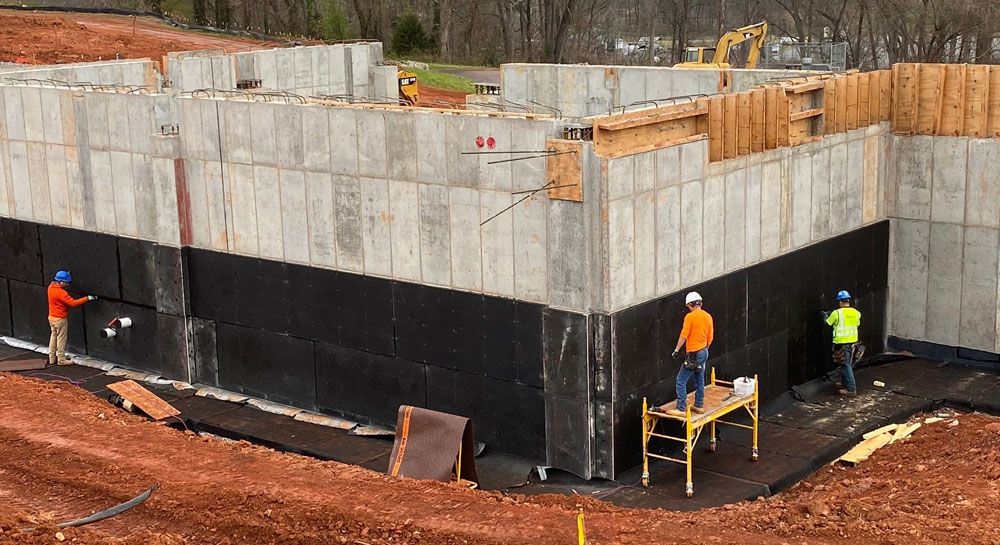

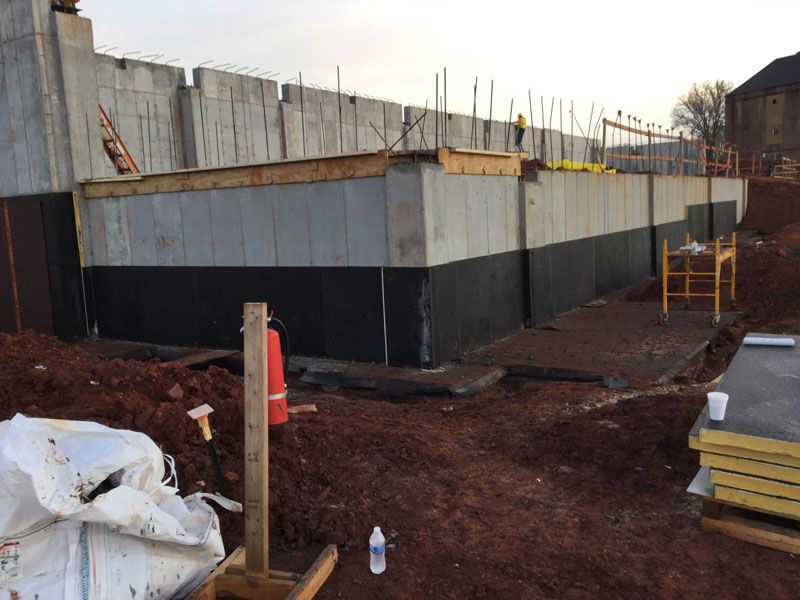

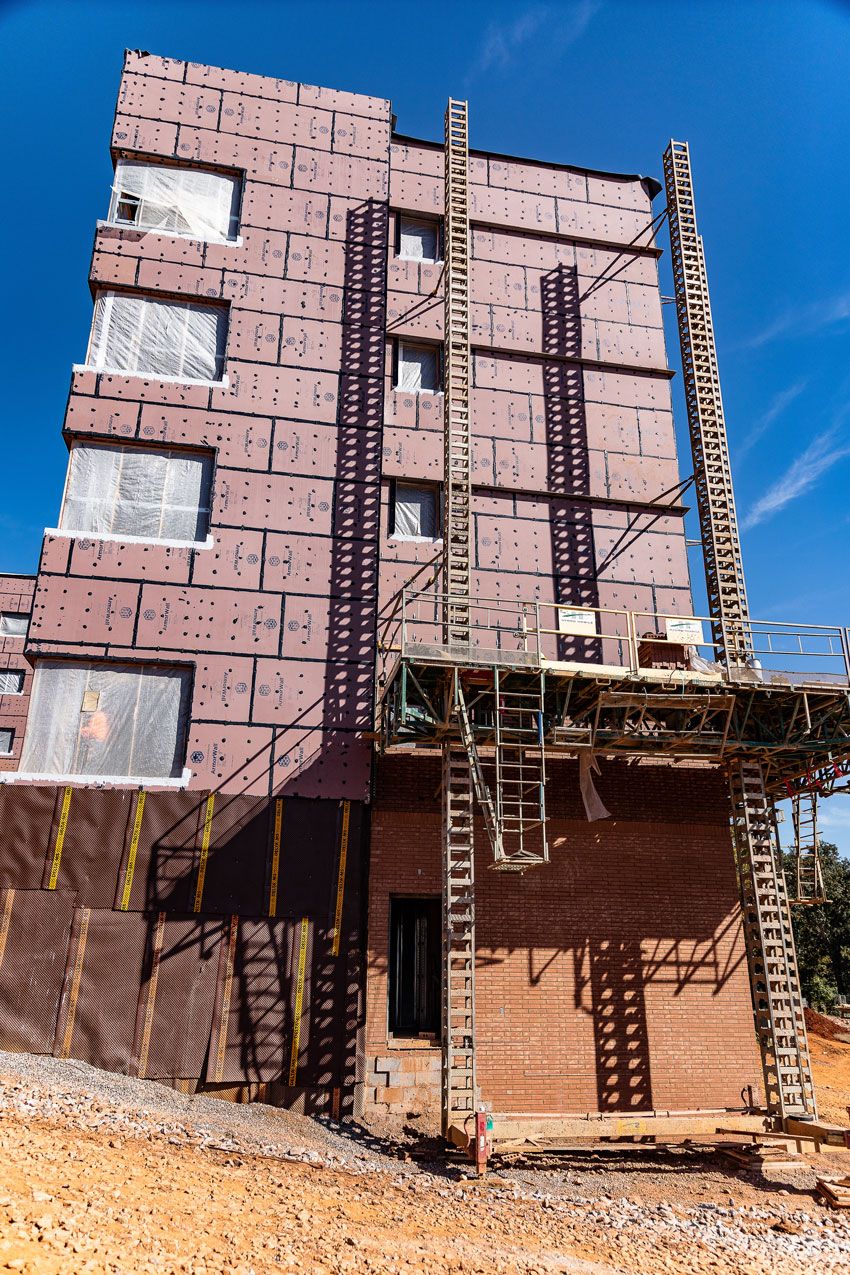

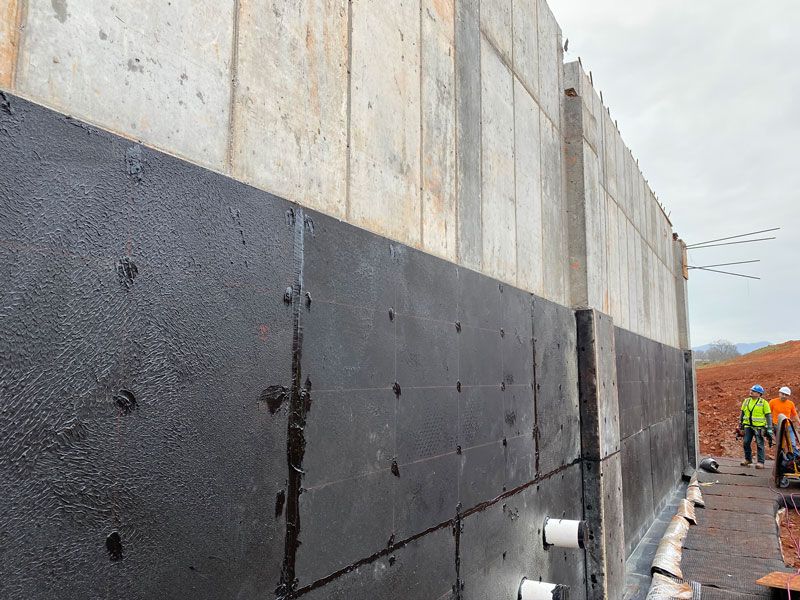

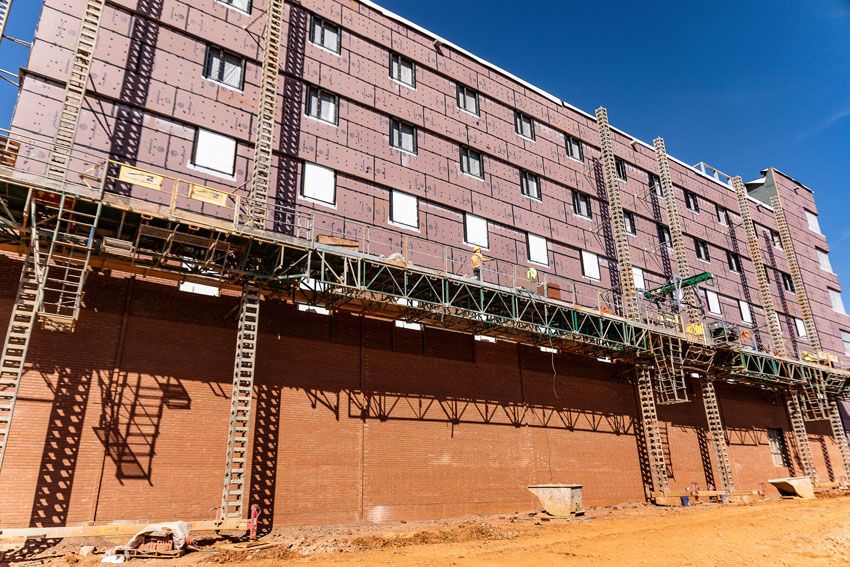

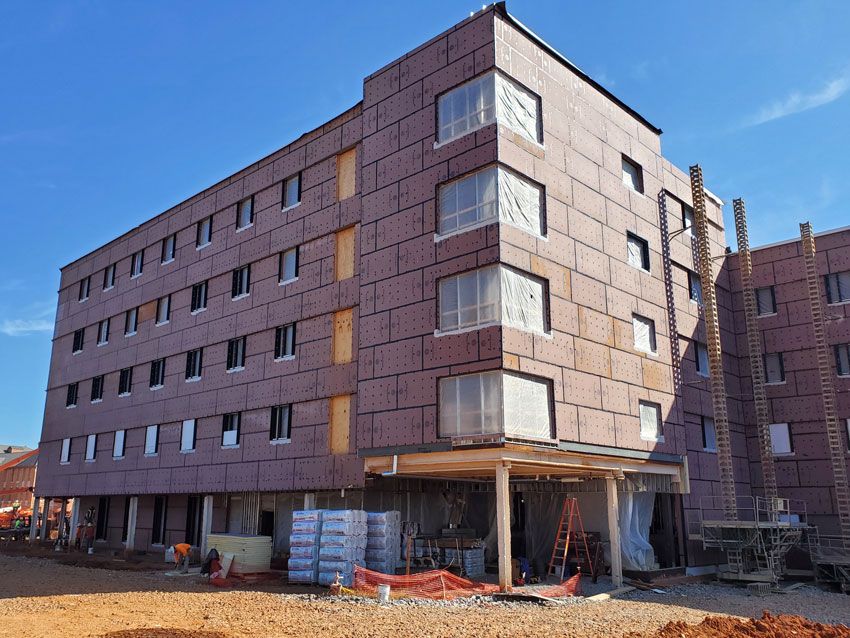

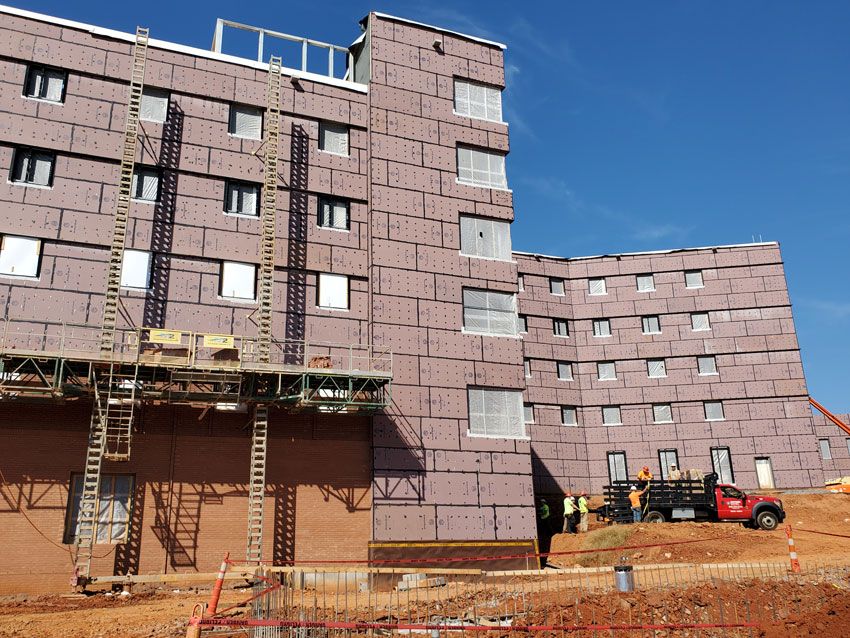

Installation started with ArmorWall BG around the foundation and followed up with ArmorWall VP on the above grade exterior walls. The installation went so fast that the install team had to slow down several times!

Contractor Friendly

Using ArmorWall VP saved an entire trade from being added to the job, reducing trade overlap and creating less work for the general contractor.

Weather Was No Issue

ArmorWall is a building enclosure solution that can be installed quickly and in many different types of weather to help clients save time and money on projects, particularly those taking place in the rainy spring season of North Carolina.








INTERVIEW

Nathan Collins, Precision Walls, Inc.

What benefits made you interested in using ArmorWall?
“What I like best about ArmorWall is having the integrated water-resistant barrier and structural insulated sheathing in one product.”

How did the installation process go?
“Once we identified the most efficient way to install ArmorWall, it was really easy. Our guys became very proficient, saving money for our client rather than just making budget.”

Do you feel by using ArmorWall, the project was weathered in faster?
“The project was 100% weathered in faster. We were five to six weeks behind on the construction schedule due to delays with steel. ArmorWall got us back on track. We were framed and sheathed in six weeks, saving us three to four weeks on the project schedule.”

Would you use ArmorWall again?
“I would absolutely use the ArmorWall series again. You are cutting out all the extra parts that generally delay a job due to inspections. With ArmorWall, you have a one stop shop that creates a seamless process from start to finish. Not to mention the excellent customer service you receive had any concerns arise. I don’t think we could have finished the project as early and as cost effectively without ArmorWall.”

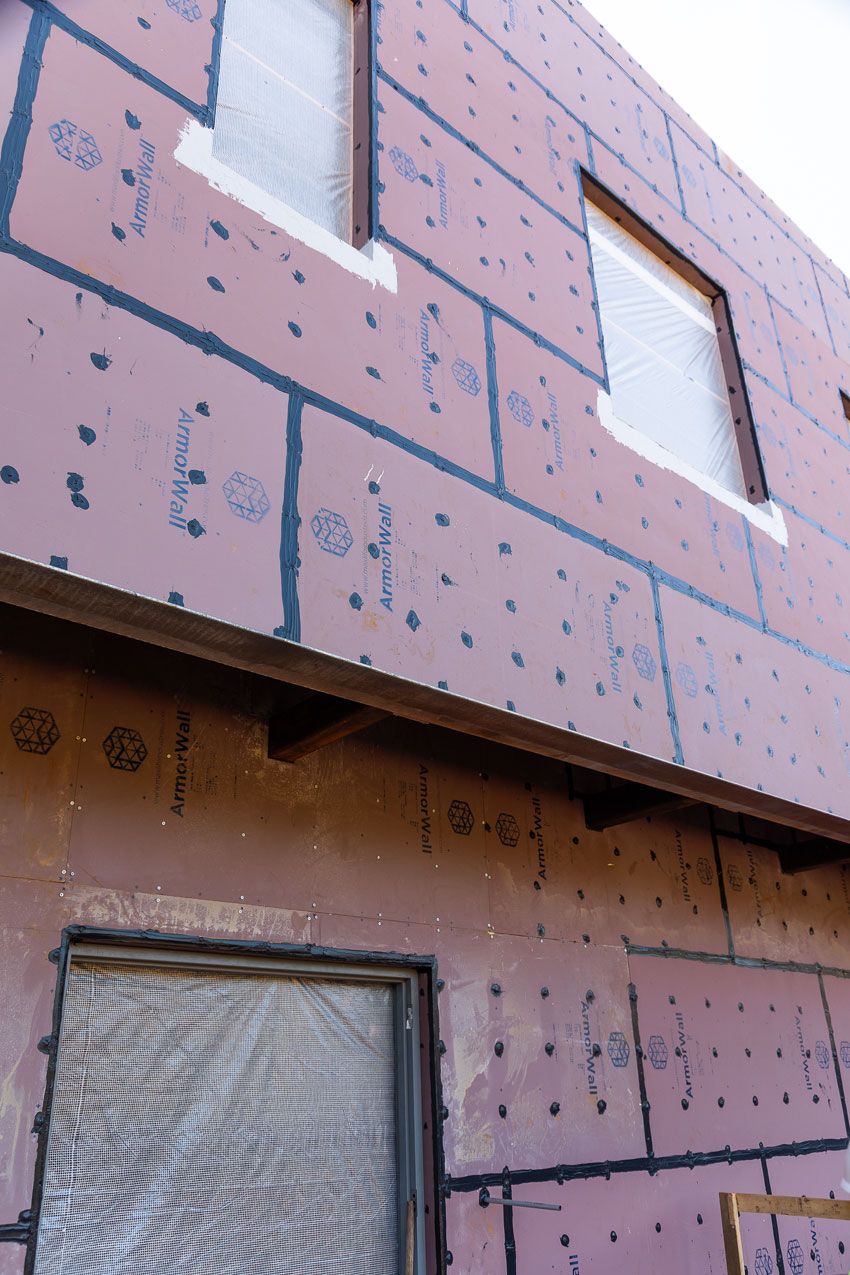

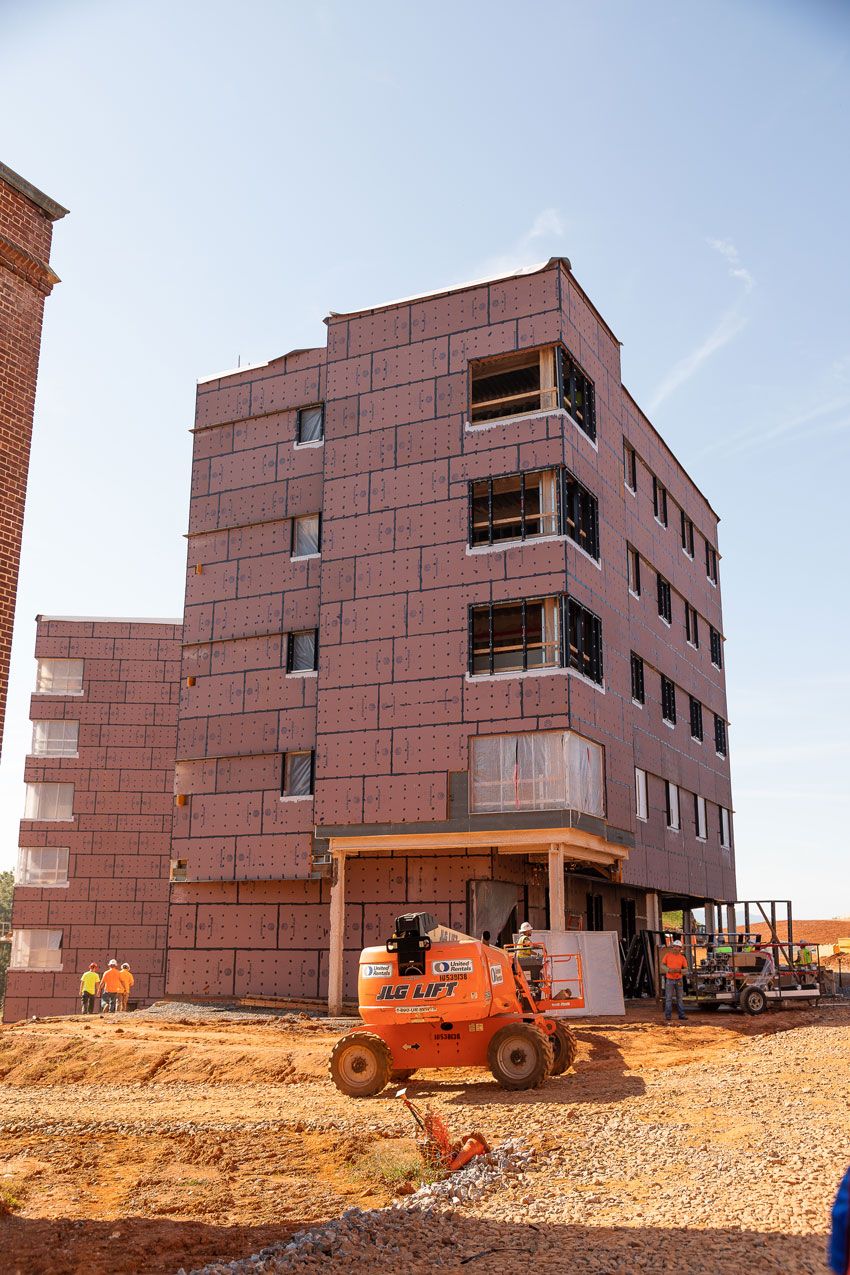

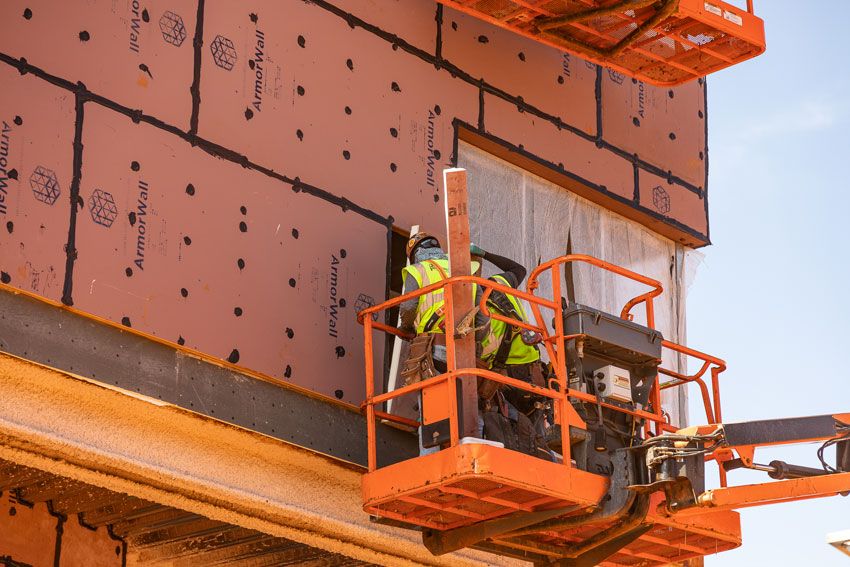

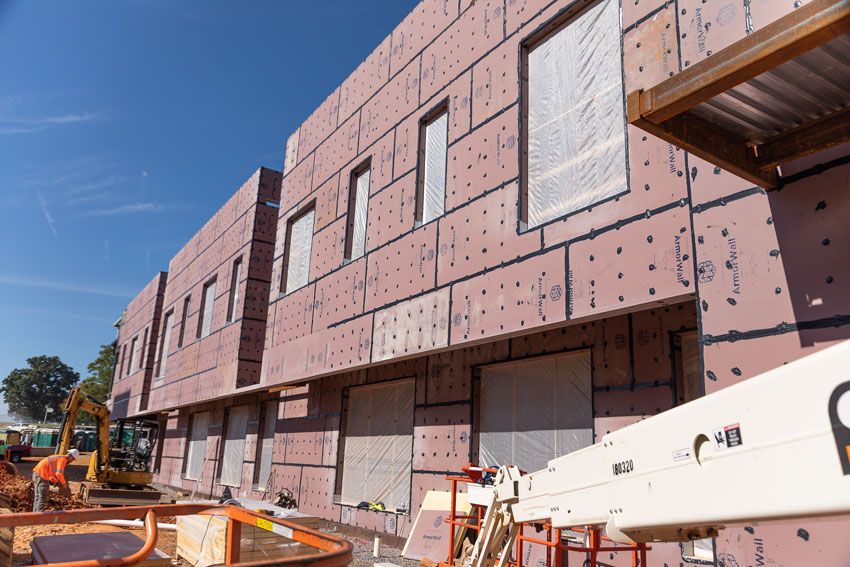

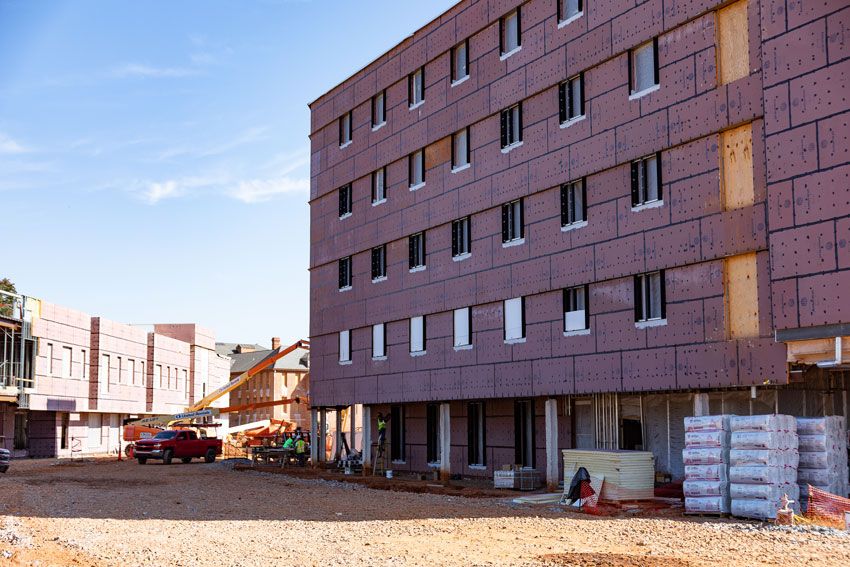

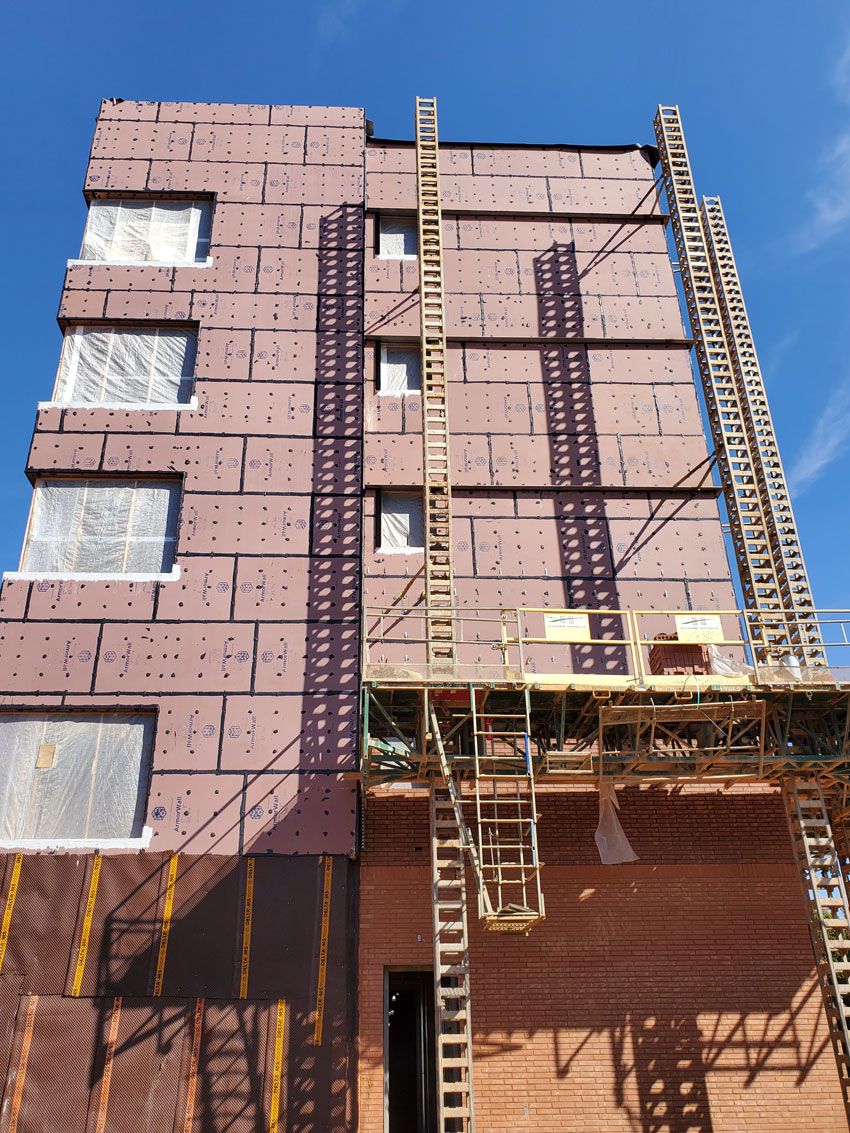

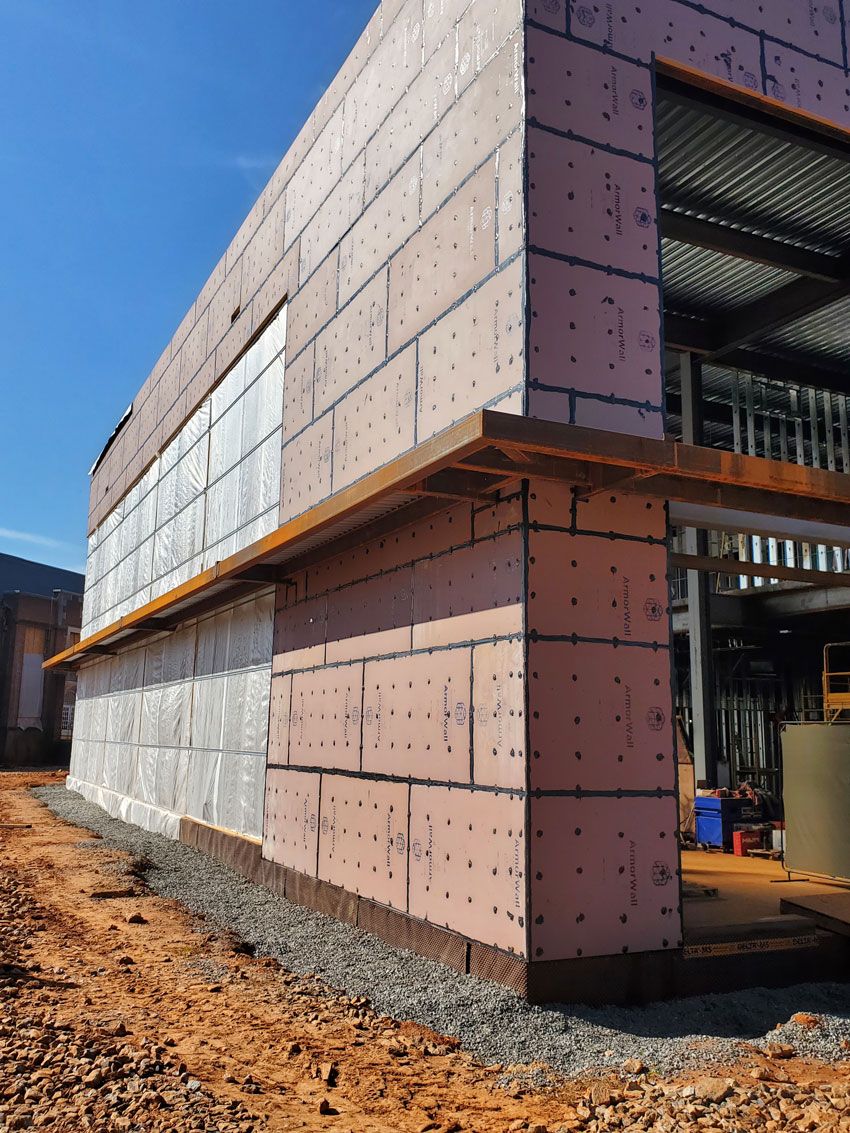

Photos
